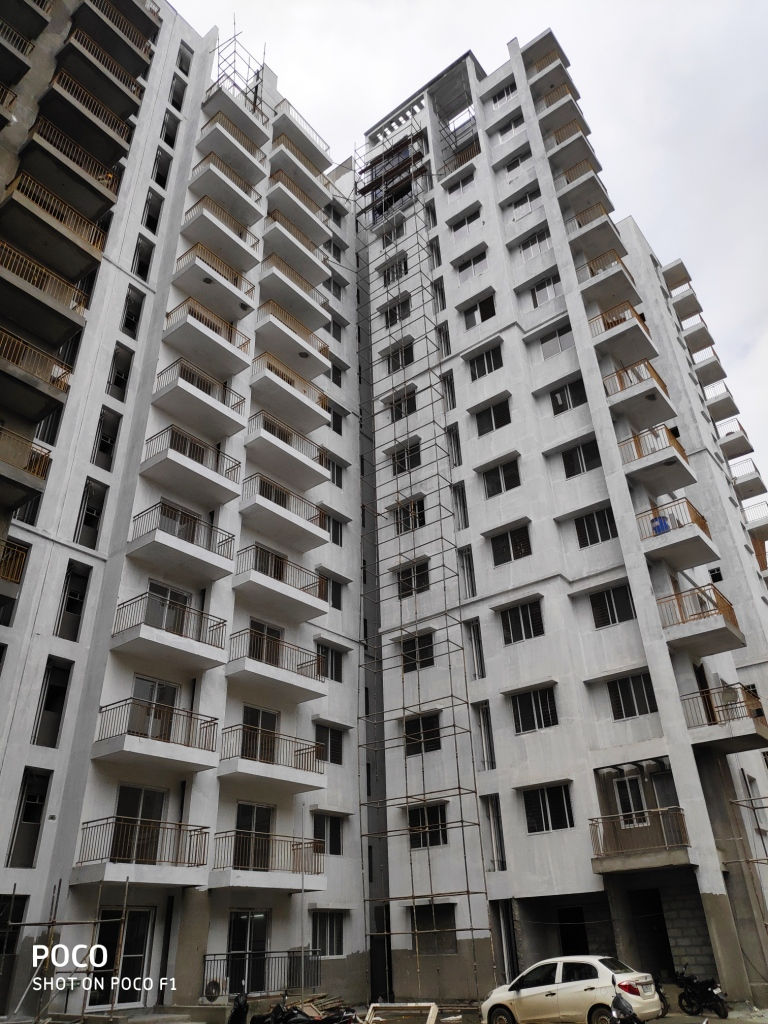

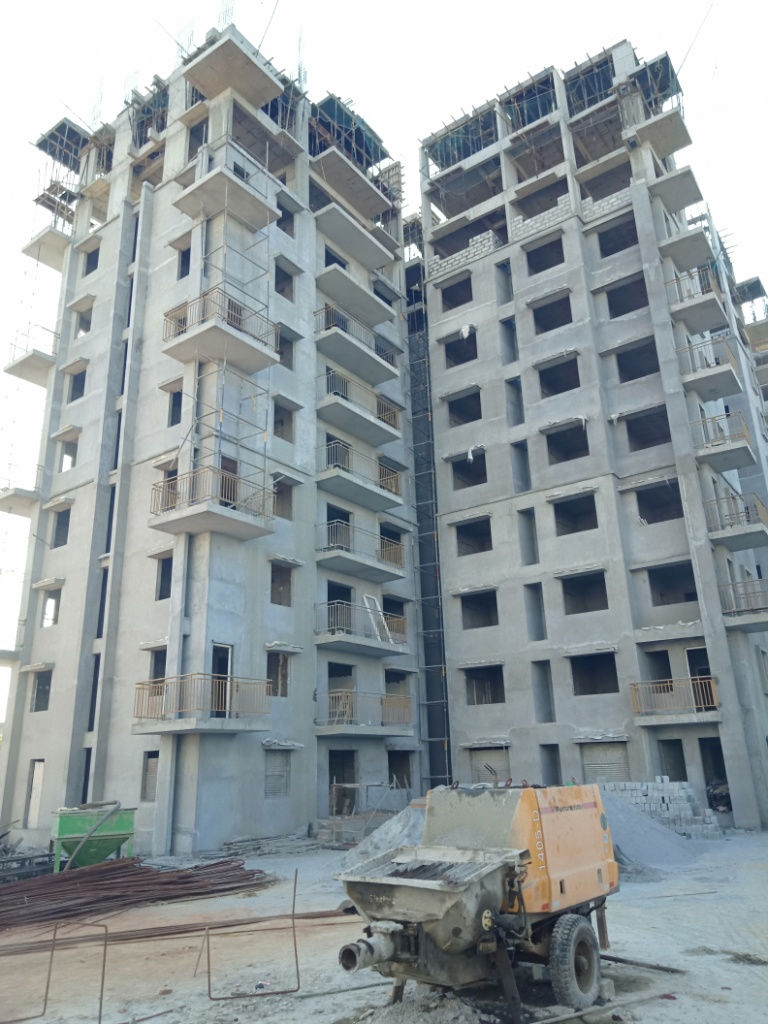

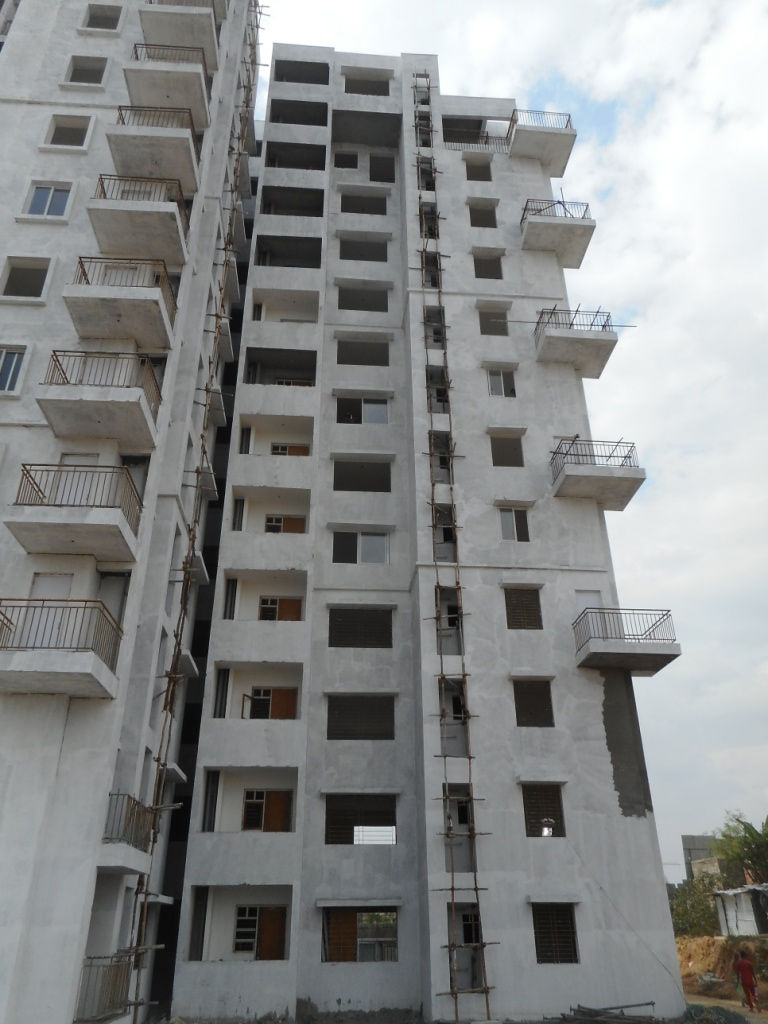

Project Status

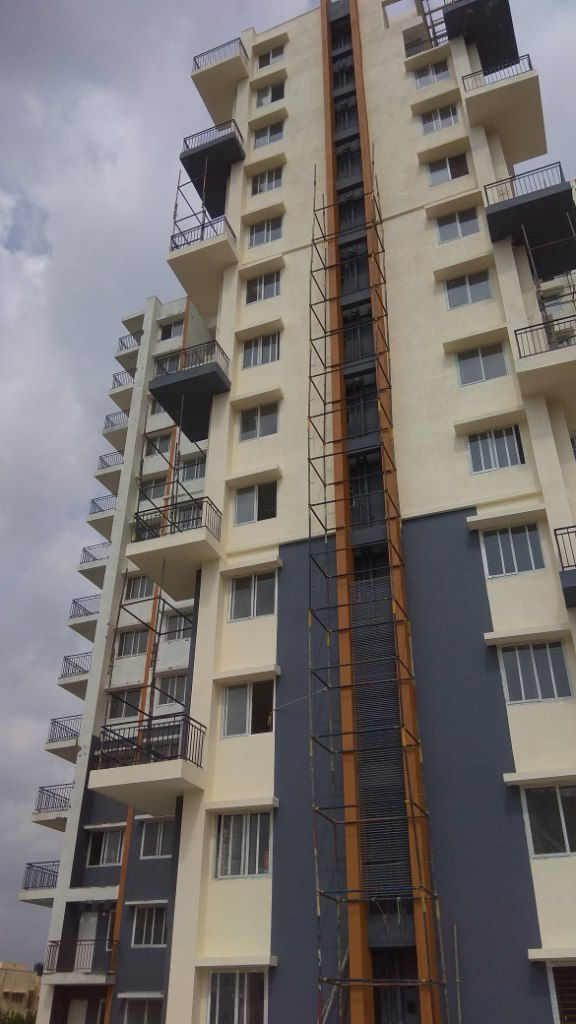

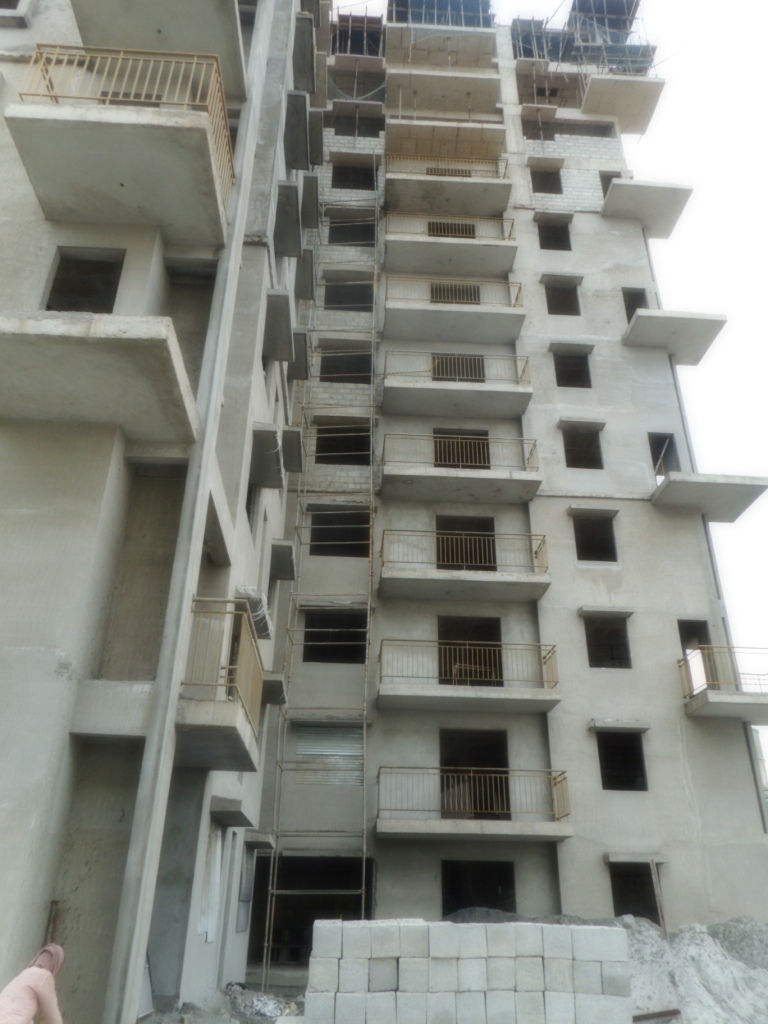

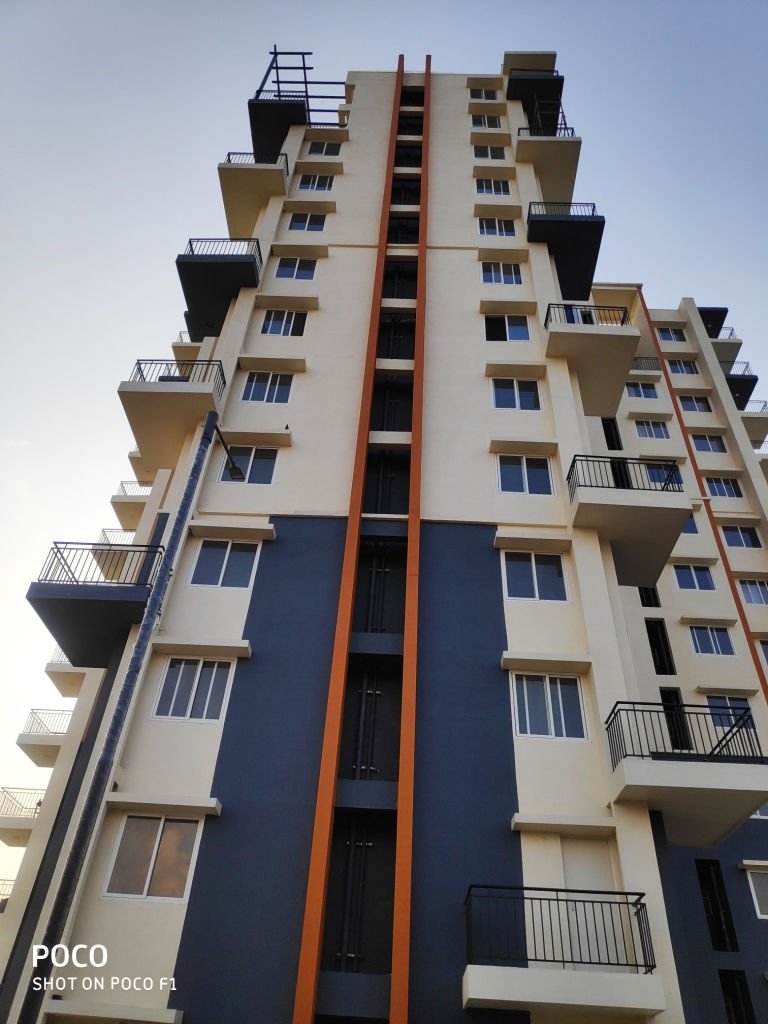

Tower 1A
-

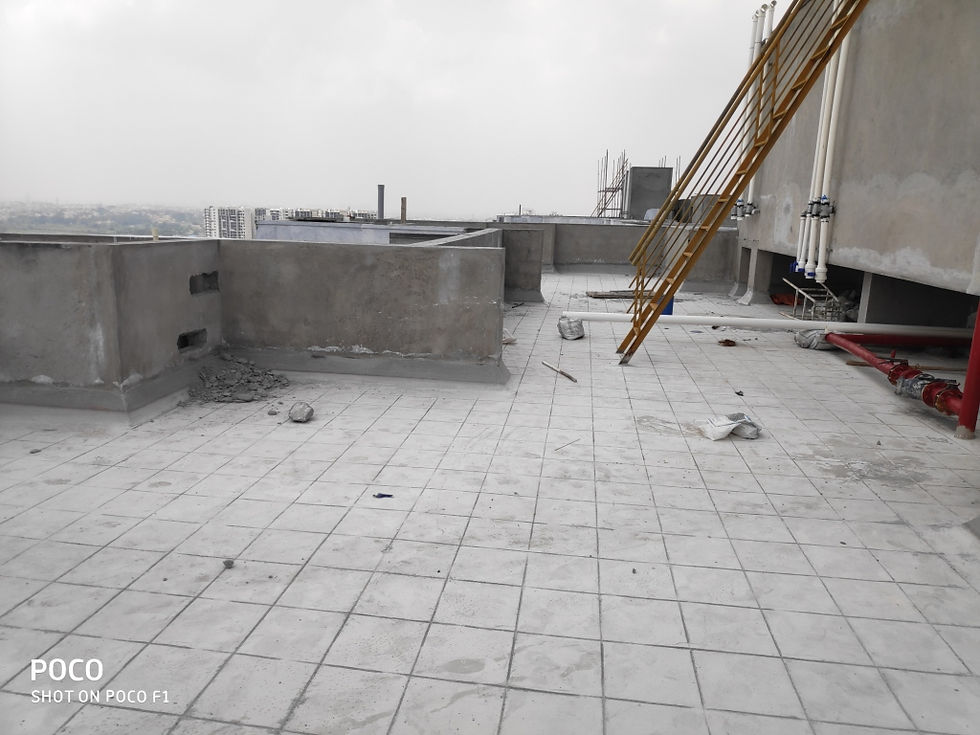

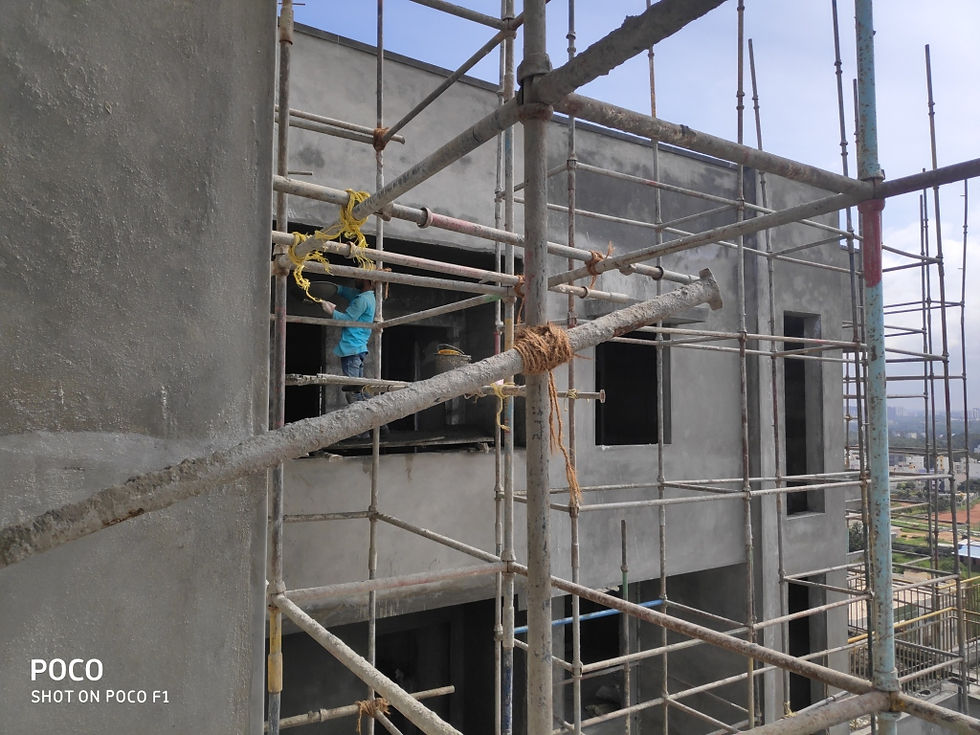

Terrace lighting arrest work completed.
-
Terrace ring mainline work completed.
-

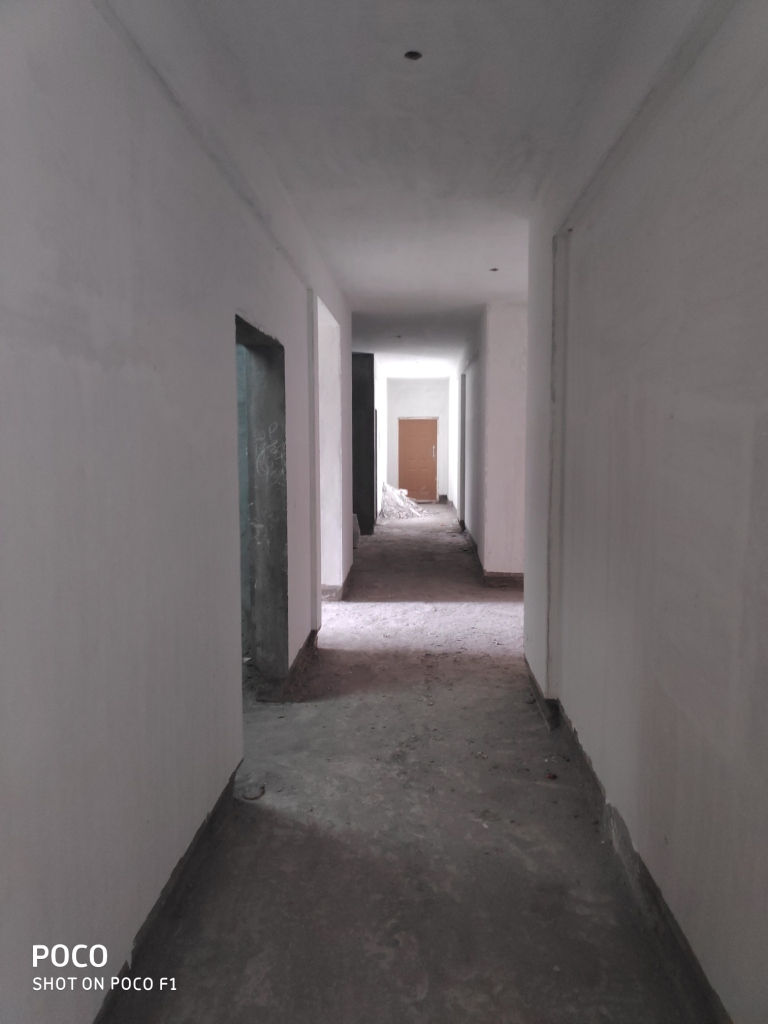

Terrace ducts and shafts civil work completed (except top covering)
-
Basement lobby blockwork and plastering work completed.
-

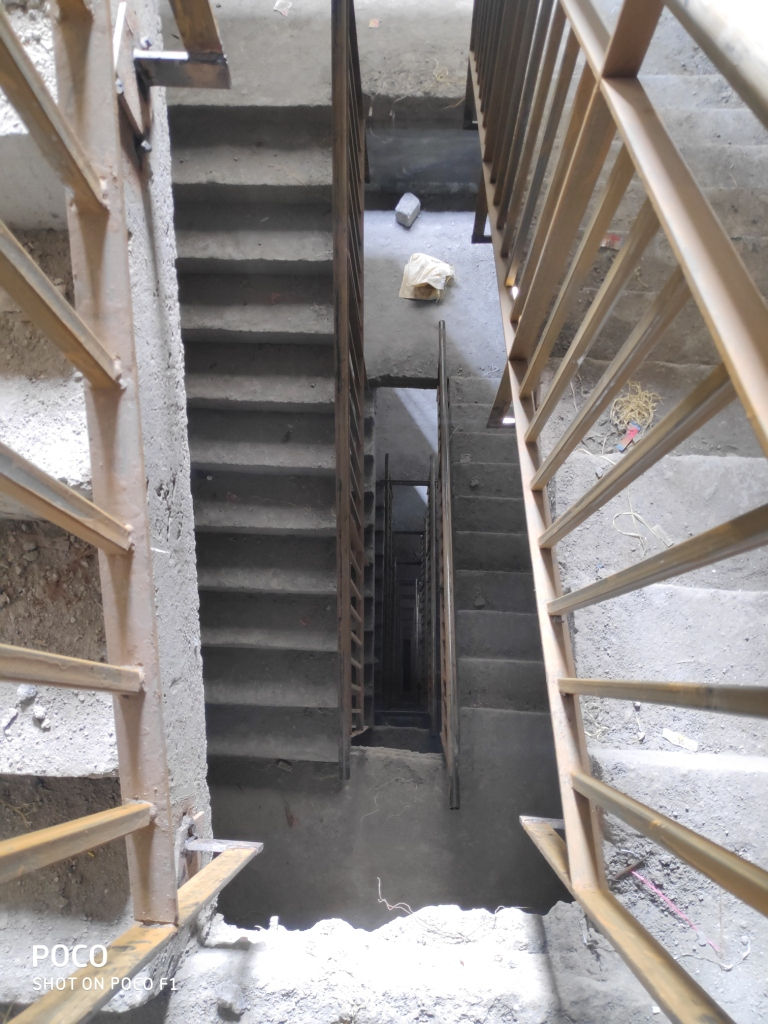

Staircase railings fixing works completed (Both staircase)
-
Door frames fixing work completed
-
Window Grills fixing work completed
-

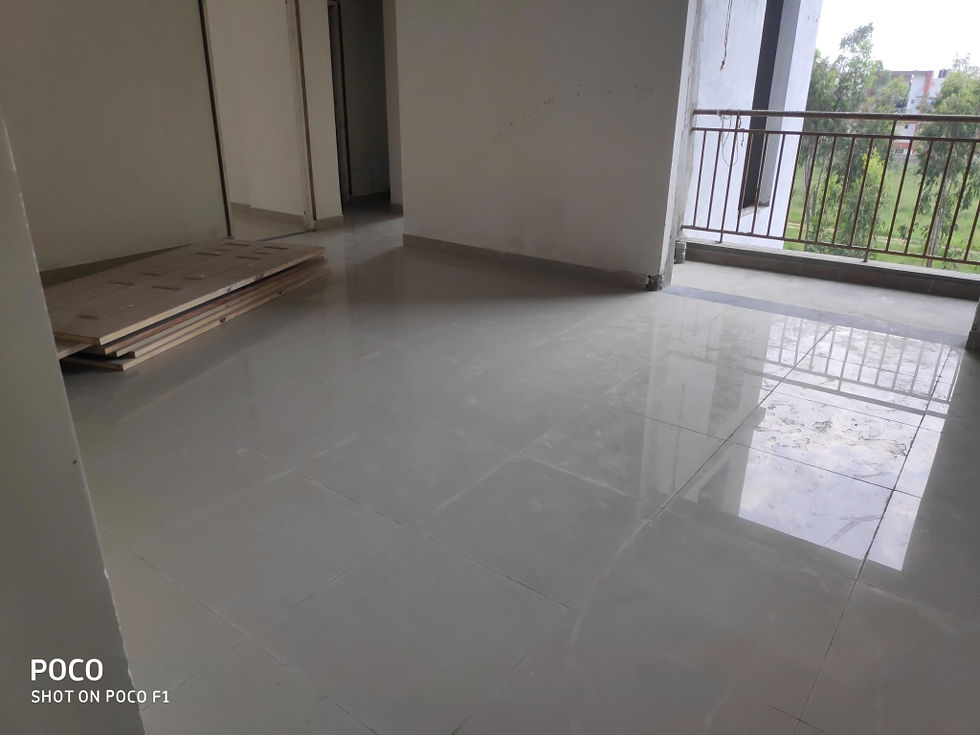

Tiling work up to 12th floor completed (balance under progress)
-
Flats internal electrical & plumbing work up to 11th floor completed, 12 & 13th under progress
-
Corridor electrical work completed (except stilt floor)
-
Toilets false ceiling works 8th floor completed, above floors under progress
-

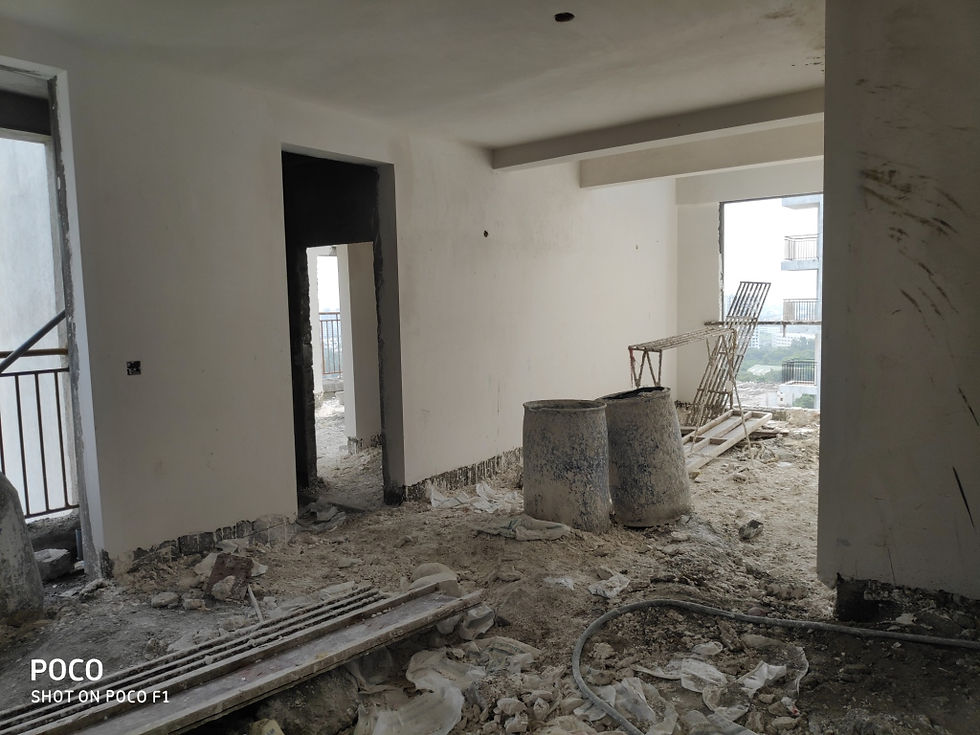

Internal painting work like primer & putty work ground to 11th floor under progress
-
External one coat colour yet to start.
-
UPVC windows fixing works overall 90% completed
-
Internal joinery works up to 11th floor completed. Above floors under progress
-
Lift front granite cladding works up to 10th floor completed. Balance under progress
-

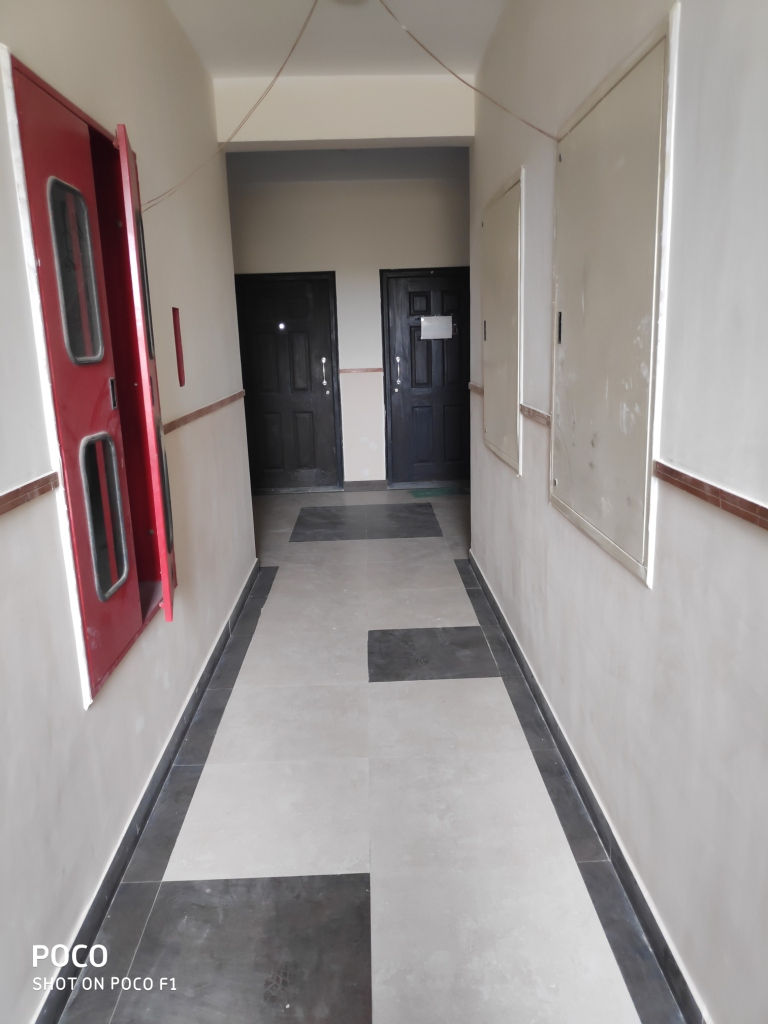

Staircase & Corridor tiling works completed
-

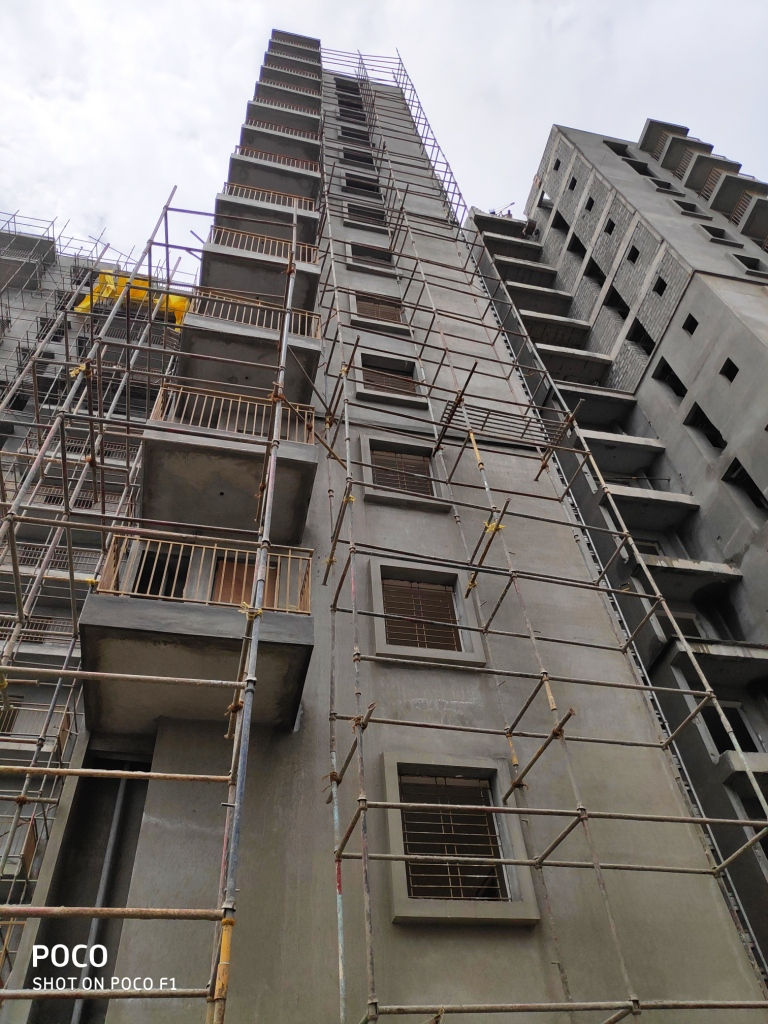

Lift installation works under progress
​

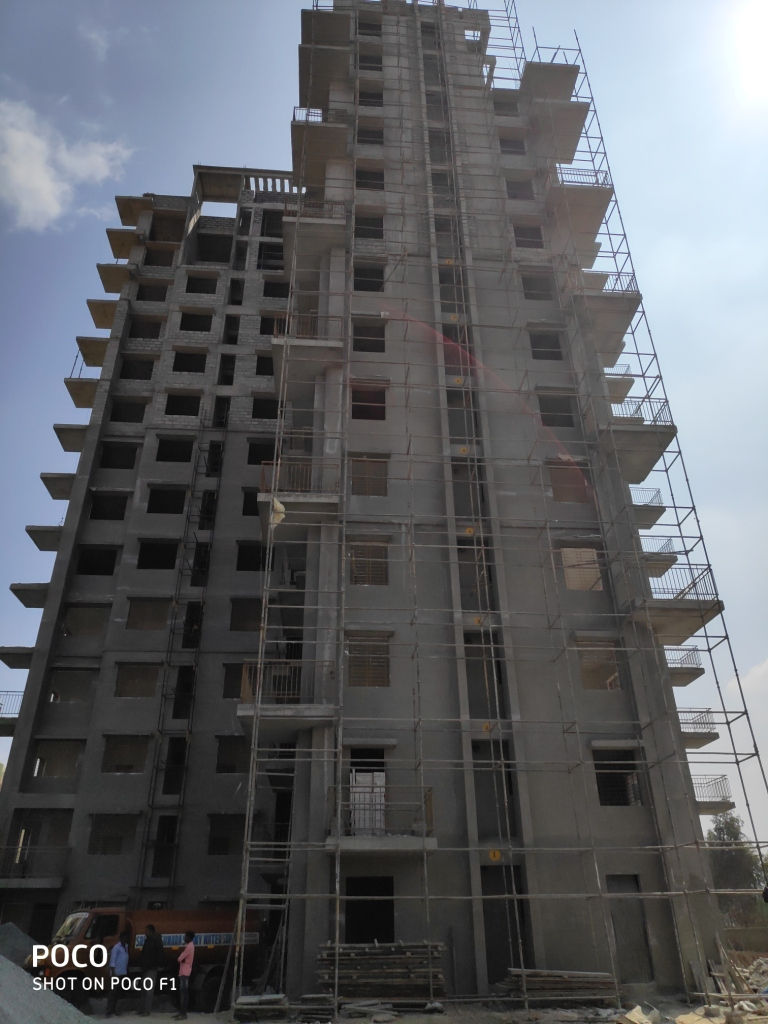

Tower 1 B
-
Terrace waterproofing works completed
-
All sides plastering works completed.
-
Block works completed (except basement and electrical rooms)
-
Internal plastering 100% completed
-
Terrace OHT waterproofing & plastering work completed
-
Door frame fixing up to 9th floor completed. Above floors under progress
-
Window grill fixing up to 7th floor completed (Balance after UPVC windows fixing)
-
Internal tiling works up to 7th floor completed, 8th & 9th floor under progress
-
Internal plumbing work completed
-
Internal electrical chiselling works completed. Wire pulling up to 3rd floor completed
-
Terrace ring mail line works completed
-
Lift front door frame fixing work under progress
-
Terrace ducts and shafts civil work completed (except top covering)

Tower 2A & 2B
-
Flats hand over work under progress (clients)
-
In all flats snagging work under progress (clients checklist for hand over)
-
In all flats plumbing fixtures fixing work completed
-
In the corridor and staircase housekeeping work under progress
-
In all floors maintenance work under progress
Basement works
-
Lower & Upper Exit Ramp flooring concrete and finishing work completed.
-
Lower & Upper Entry Ramp flooring concrete and finishing work yet to start.
-
Upper & Upper basement Gas cutting work completed (all sides RCC wall studs & Columns)
-
Upper basement screed concrete completed
-

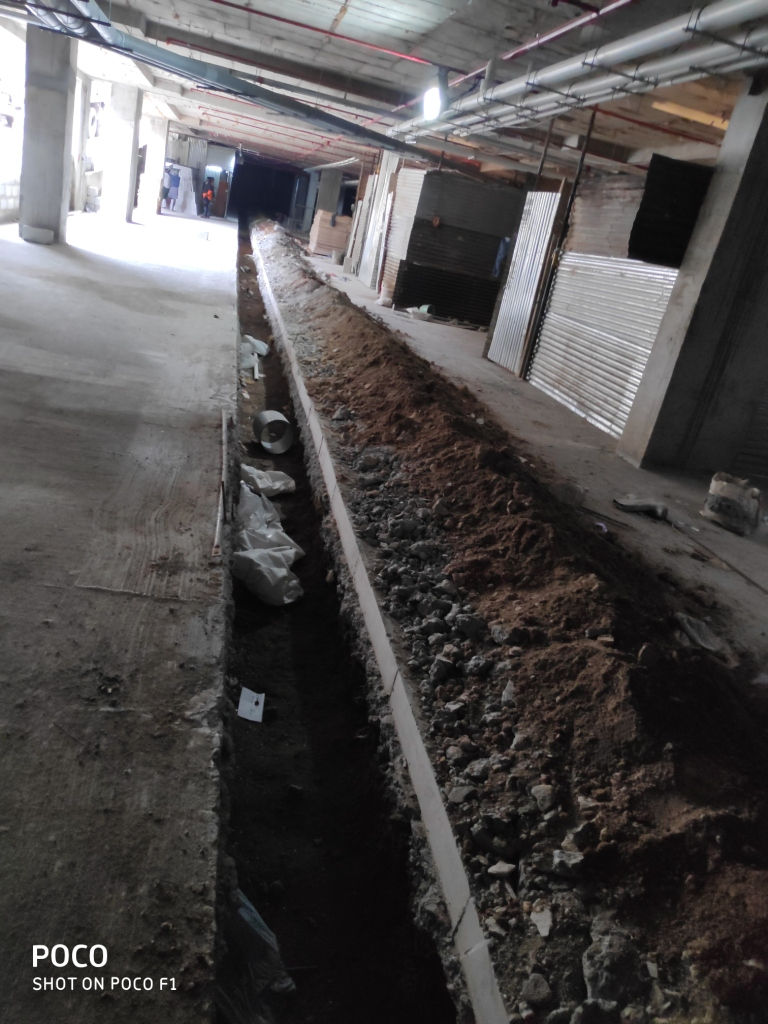

Fire fighting pipeline fixing work completed
-

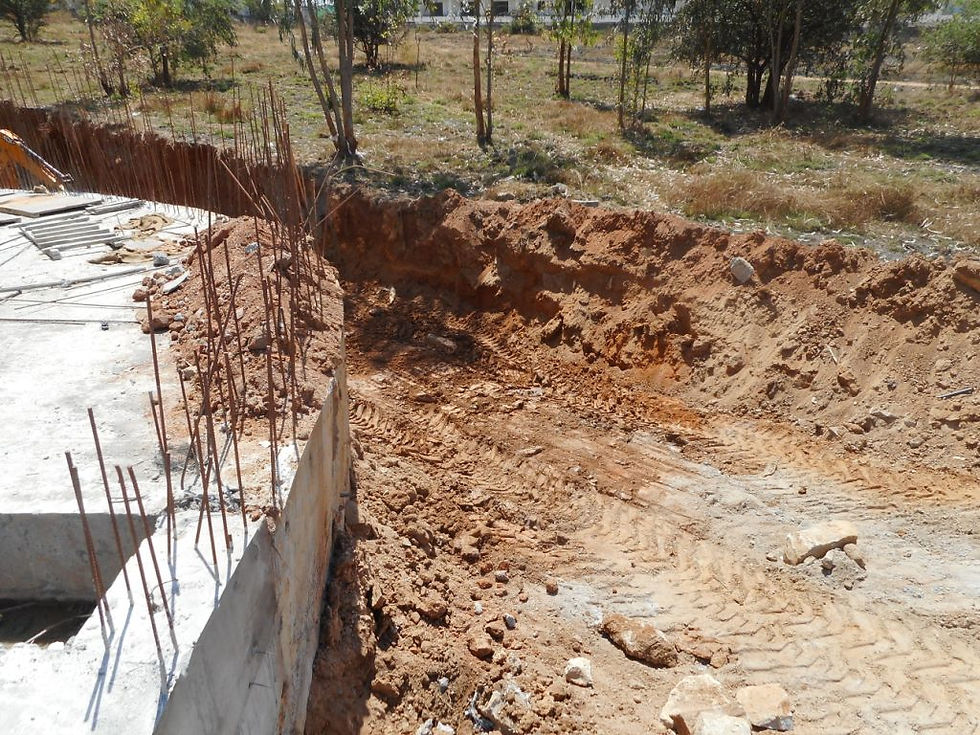

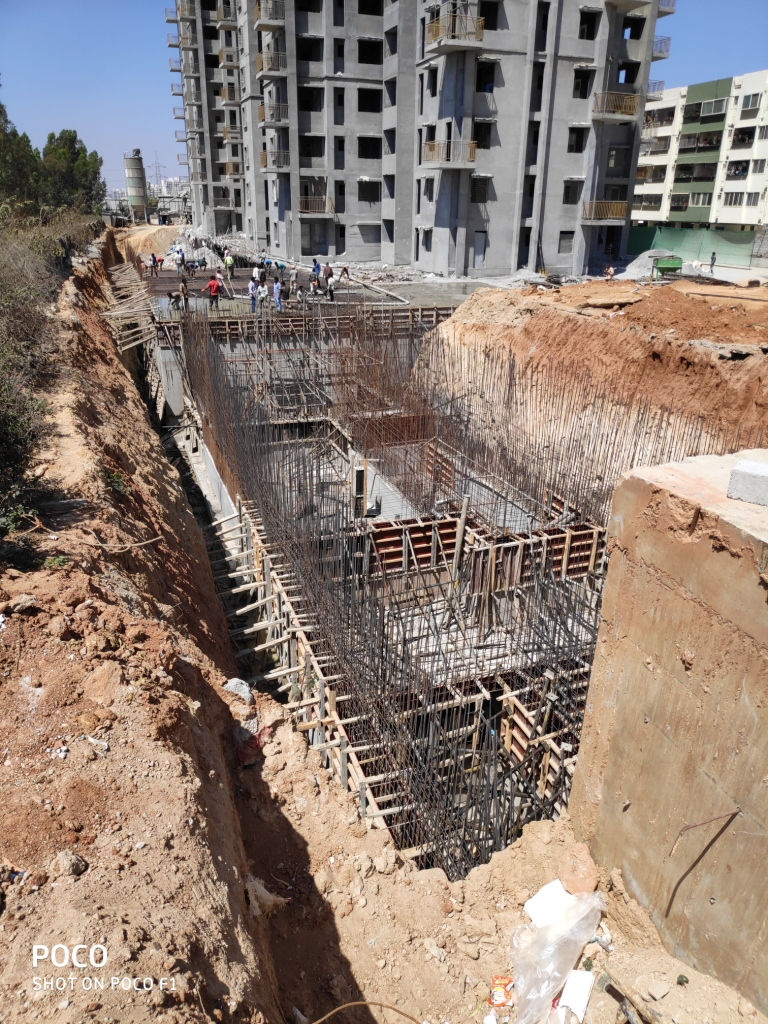

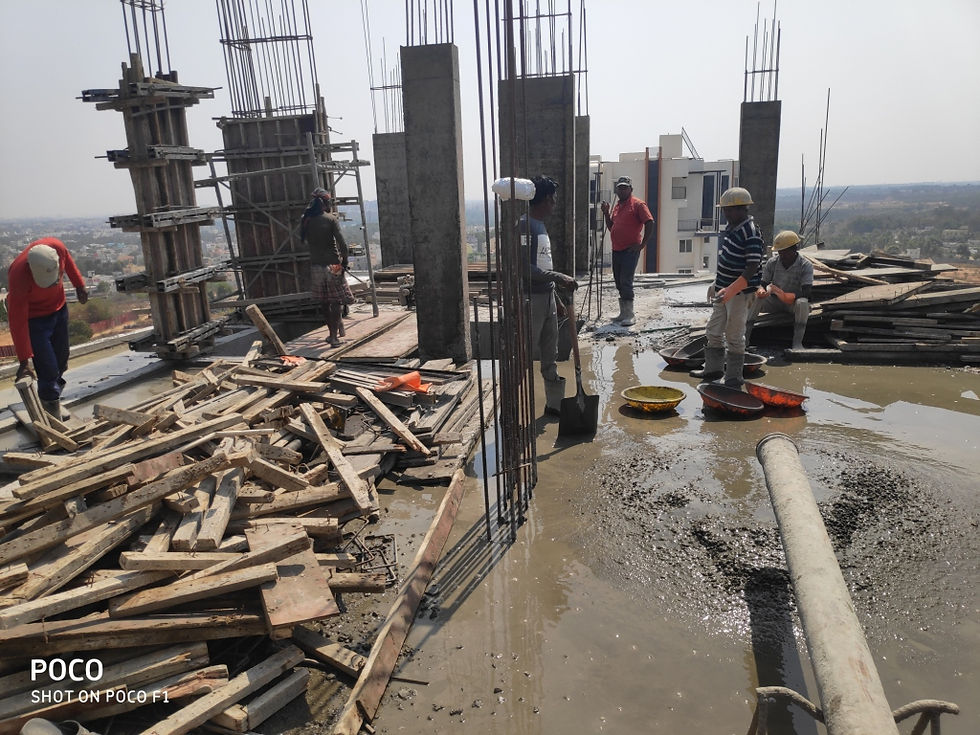

From 1A podium to 2A Upper basement entry RCC work completed (Ready to access directly to upper basement)
-
2 A & 2B Upper basement housekeeping work under progress
​
External works (Hardscape & Softscape)
-

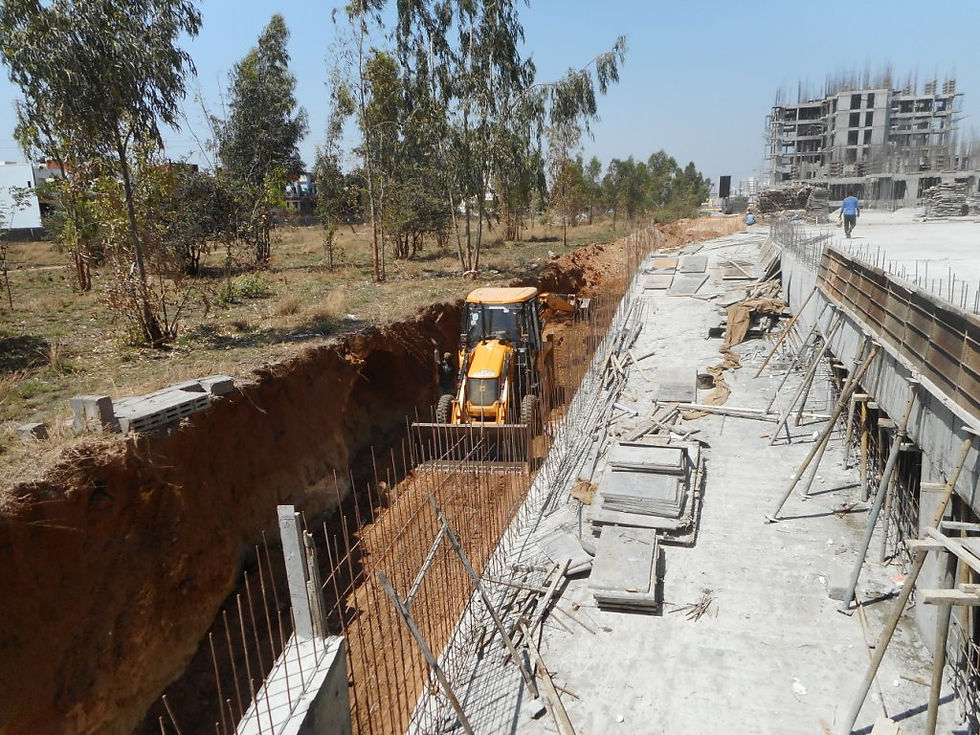

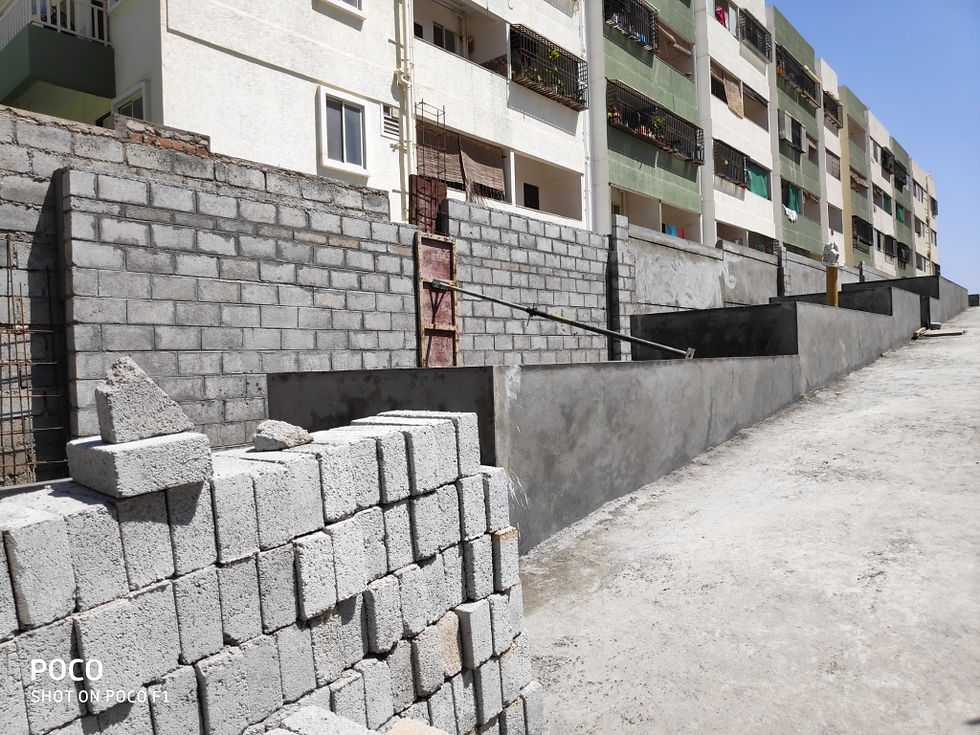

Northside compound with drainwork completed up to 1A Tower Entrance of the podium
-
Southside compound with Drainwork completed up to 1A Tower Entrance of the podium
-
Eastside compound with feature elevation work completed
-
Northside Courtyard work completed in 2A & 2B towers (Southside under progress)
-
Electrical poles fixing works completed
-
STP RCC walls concrete work completed, STP above ramp works RCC works completed
-
Front compound plastering work under progress.
-
Front Gate Structure works completed. Finishing works under progress
-
Security cabin structure and plastering work completed
-

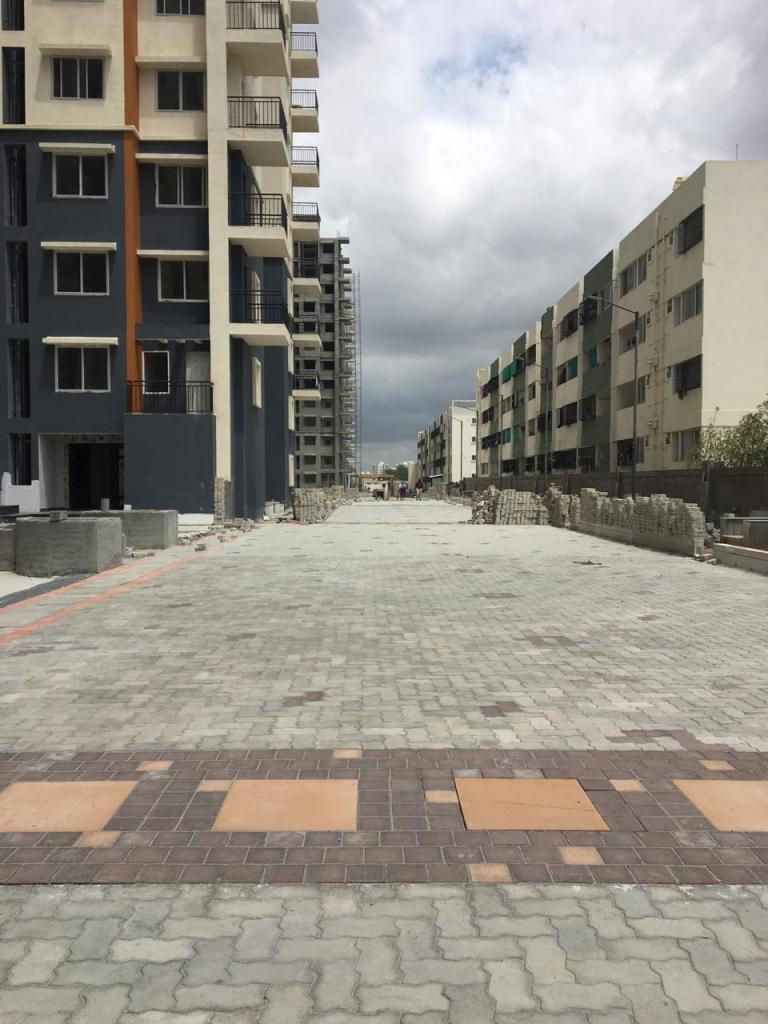

Pathway pavers in 2A & 2B tower north side completed, south side under progress

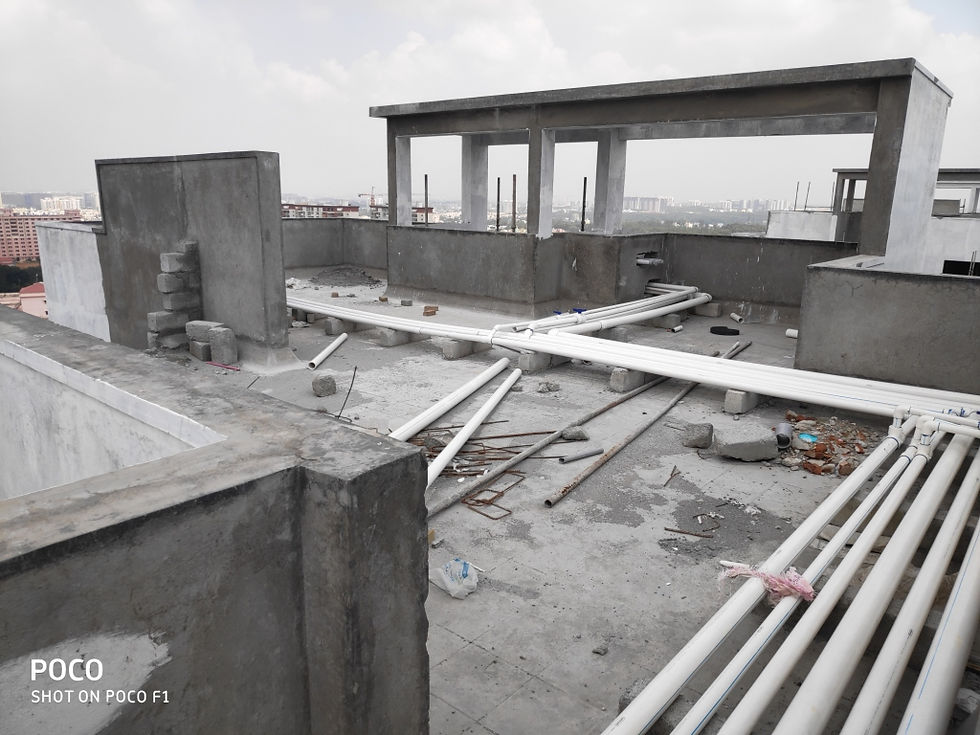

Tower 1A​
-
Terrace ring mail line work completed
-
Terrace ducts and shafts civil work completed except top covering
-
Basement lobby block work and plastering work completed
-
Staircase railing work completed (both staircase)
-
Door frame fixing work completed
-
Window grills fixing work completed
-
Tiling work up to 12th floor completed. Balance under progress
-
Flats internal electrical & plumbing work up to 11th floor completed, 12th & 13th floor under progress
-
Corridor electrical work completed except stilt floor
-
Toilets false ceiling works 8th floor completed, above floors under progress
-
Internal painting works like primer and putty work ground to 11th floor under progress
-
External one coat colour yet to start
-
UPVC window fixing work overall 90% completed
-
Internal joinery work up to 11th floor completed. Above floors under progress
-
Lift front granite cladding work up to 10th floor completed. Balance under progress
-
Staircase & corridor tiling work completed
-

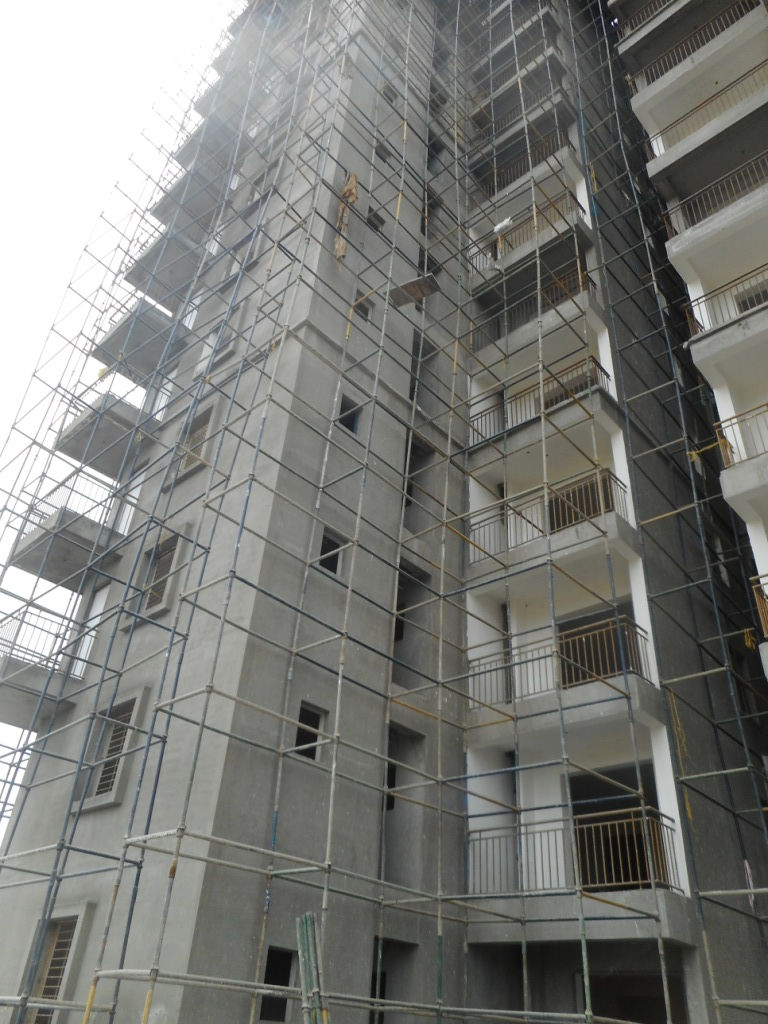

Lift installation work under progress
​
Tower 1 B
-
Terrace waterproofing work completed
-
All sides plastering work completed
-
Block work completed except basement and electrical rooms
-
Internal plastering 100 % completed
-
Terrace OHT water proofing and plastering work completed
-
Door frame fixing up to 9th floor completed. Above floors under progress
-
Window grill fixing up to 7th floor completed. Balance after UPVC window fixing
-
Internal tiling work up to 7th floor completed, 8th and 9th floor under progress
-
Internal plumbing work completed
-
Internal electrical chiseling work completed. Wire pulling up to 3rd floor completed
-
Terrace ring mail line work completed
-
Lift front door frame fixing work under progress
-
Terrace ducts and shafts civil works completed except top covering
​
Basement works
-
Lower and upper exit ramp flooring concrete and finishing work completed
-
Lower and upper entry ramp flooring concrete and finishing work yet to start
-
Upper basement Gas cutting work completed (all sides RCC wall studs & columns)
-
Upper basement screed concrete completed
-
Fire fighting pipe line fixing work completed
-
From 1A podium to 2A upper basement entry RCC work completed (ready to access directly to upper basement)
-
2A and 2B upper basement house keeping work under progress
External work (Hardscape and Softscape)
-
North and south side compound with drain work completed up to Tower 1A entrance of the podium
-
East side compound with feature elevation work completed
-
North side courtyard work completed in 2A and 2B towers. South side under progress
-
Electrical pole fixing work completed
-
STP RCC walls concrete work completed, STP above ramp work RCC work completed
-
Front compound plastering work under progress
-
Front gate structure work completed. Finishing work under progress
-
Security cabin structure and plastering work completed
-
Pathway pavers in Tower 2A and 2B north side completed, south side under progress

Tower 1 A
-
Lift frame fixing works under progress
-

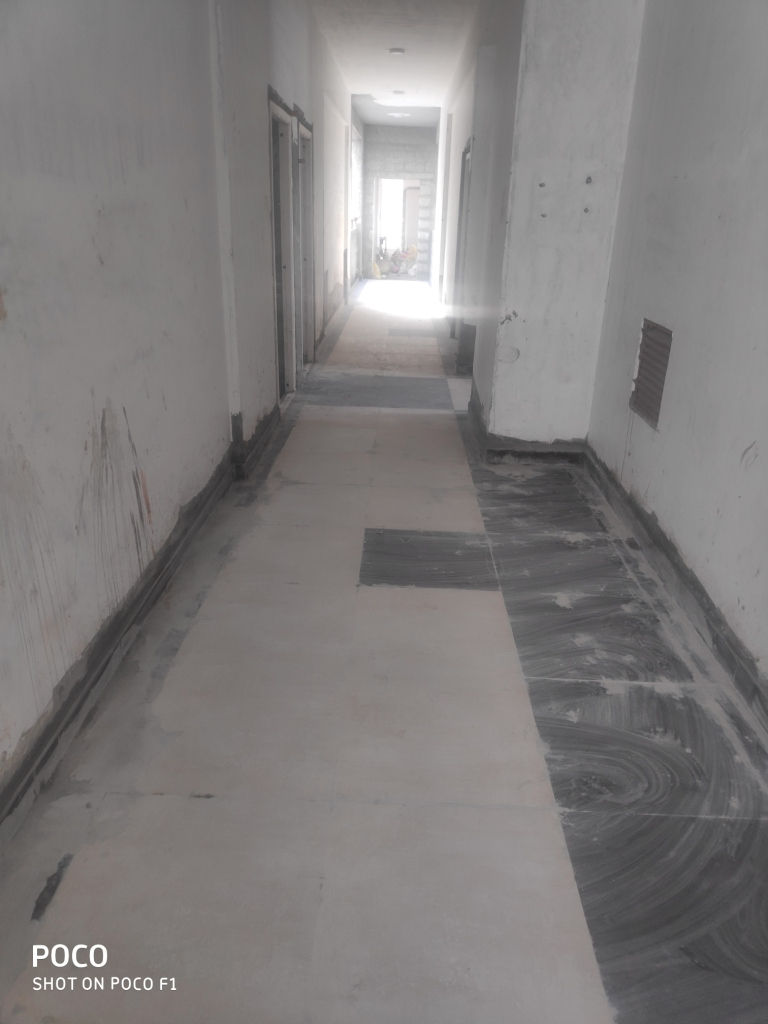

Corridor tiles from first to fourth floor under progress
-
Corridor hand railing works under progress
-
Basement lobby plastering under progress
-
Staircase hand railings fixing work ground to penthouse completed
-
Door frame fixing in penthouses under progress
-
Window grills above 11th floor under progress
-
Tiling work 12th floor & penthouses under progress
-
Internal Toilet electrical wires pulling up to 8th completed, above 9th floor under progress
-
Toilet false ceiling work stared. Fourth floor under progress.
-
Internal painting work, primer & putty up to 9th floor completed, balance under progress
-
Corridors up to 5th floor primer & putty work completed. External primer work completed
-
UPVC window fixing work overall 90% completed (Balcony french windows from 8th to penthouse pending)
-
Internal joinery work up to 10th floor completed. Above floors under progress
-
Internal flat plumbing work completed. Duct & balcony lines under progress
-
Terrece ring main lines under progress. OHT lines under progress
​
Tower 1B
-
Terrace waterproofing work 100 % completed
-
All sides plastering work completed (except OTS areas)
-
North side OTS plastering completed, south side under progress
-
Block work ground to terrace 100% completed (Basement lobby area under progress)
-
Internal rough plastering 100 % completed (toilet and kitchen area)
-
Internal plastering up to 8th floor completed (9th & 10th under progress)
-
Door frame fixing above 8th floor under progress
-
Window grill fixing up to 7th floor completed. Balance under progress
-
Internal tiling work up to 5th floor completed, 6th floor under progress
-
Internal plumbing works completed. Duct lines under progress
-
Internal electrical work chiselling and conduit fixing work completed
-
Electrical wire pulling work in 2nd floor under progress
-
Lift shaft scaffolding under progress
​
Tower 2A & 2B
-
Flats handing over work under progress
-
In all flats snagging work under progress
-
In all flats plumbing fixture fixing work completed
-
In the corridor and staircase house keeping works under progress
-
In all floors maintaince works under progress
​
External work (Hardscape & Softscape)
-
North side compound with drain work completed up to Tower 2A entrance of the podium
-
South side compound with drain work completed up to Tower 2A entrance of the podium
-
East side compound with feature elavation works completed
-
North side courtyard work completed in Towers 2A&2B. South side under progress
-
Electrical poles fixing work completed
-
STP RCC walls concrete work completed.
-
Front compound plastering work under progress
-
Front gate structure work completed. Finishing work under progress
-
Security cabin structure and plastering work completed
-
Pathway pavers in Tower 2A&2B north side completed, south side under progress

Tower 1 A
-
Terrace water proofing works completed
-
Upper terrace OHT internal waterproofing and testing completed
-
Upper terrace plastering works completed
-
Basement lobby block work under progress
-
Staircase railing fitting work up to 8th floor completed (Common staircase)
-
Door frame fixing up to 11th floor completed, 12th floor under progress
-
Window grills above 8th floor under progress
-
Tiling work 10th floor under progress
-
Internal toilet electrical wires pulling up to 7th floor completed, above 8th floor under progress
-
Basement grade slab concrete works completed, ramp works under progress
-
Toilet false ceiling works stared. Fourth floor under progress
-
Internal painting work like primer & putty work ground to 8th floor under progress
-
External primer works completed
-
UPVC window fixing work overall 90% completed
-
Internal joinery work up to 10th floor completed. Above floors under progress
-
Lift front wall block work completed. Lift installation basic work started
-
Staircase & corridor tiling work started (from ground to terrace floor) up to 7th floor completed
-
Internal water proofing works completed
​
Tower 1B
-
Terrace waterproofing work 50% completed
-
East and south plastering work under progress (50% completed)
-
North side 8th floor to terrace plastering work completed
-
Block work completed except for parapet walls (Basement yet to start)
-
Internal plastering 100% completed
-
Internal water proofing works completed
-
Door frame fixing up to 7th floor completed. Above floors under progress.
-
Window grill fixing up to 7th floor completed. Balance under progress
-
Internal tiling works up to 5th floor completed, 6th floor under progress
-
Internal plumbing works 12th & 13th floor under progress
-
Internal elecrtical works 12th & 13th floor under progress
-
Lift front wall block work floor completed
-
Lift shaft work under progress
-
Electrical & Plumbing work 10th & 11th floor under progress
Tower 2A & 2B
-
Flats handing over work under progress
-
All flats snagging work under progress (Clients check list for hand over)
-
All flats plumbing fixtures fixing works completed
-
In the corridor and staircase house keeping works under progress
-
All floors maintenance work under progress
​
External Work (Hardscape & Softscape)
-
North side compound with drain work completed up to Tower 2A Entrance of the podium
-
South side compound with drain work completed up to Tower 2A Entrance of the podium
-
East side compound with feature elevation works completed
-
North side courtyard work completed in 2A & 2B Towers. South side under progress
-
Electrical poles fixing work completed
-
STP RCC walls concrete work completed, STP above ramp works RCC works completed
-
Front compound plastering work under progress
-
Front gate structure works completed. Finishing works under progress
-
Security cabin structure and plastering work completed
-
Pathway pavers in 2A & 2B tower north side completed, south side under progress

Tower 1A
-
Terrace water proofing work under progress
-
Upper terrace OHT internal waterproofing work completed. Testing under progress
-
All three sides up to terrace plastering work completed
-
Upper terrace block work completed
-
Block work in basement under progress
-
Staircase railing work under progress
-
Door frame fixing up to 10th floor completed, 11th floor under progress
-
Window grill fixing up to 7th floor completed, above 8th floor under progress
-
Internal plastering completed
-
Tiling work up to 9th floor completed. 10th floor under progress
-
Internal toilet plumbing lines completed
-
Internal toilet electrical chiseling lines & conduit fixing completed
-
Internal toilet electrical wires pulling up to 7th floor completed, above 8th floor under progress
-
Basement grade slab concrete work completed, ramp work under progress
-
Toilet false ceiling work stared, ground and first floor under progress
-
Internal painting work like primer and putty works ground to 7th floor under progress
-
External primer works completed
-
UPVC windows fixing works overall 80% completed
-
Internal joinery works up to 8th floor completed. Above floors under progress
-
Lift front wall block work completed. Lift installation basic works started
-
Staircase and corridor tiling work started (from penthouse to ground floor)
-
Internal water proofing work completed
​
Tower 1B
-
All RCC concrete work completed
-
Terrace waterproofing work started
-
North side 8th floor to terrace plastering work under progress.
-
Block works completed except parapet wall (25% completed)
-
Internal plastering penthouses under progress
-
Internal water proofing work in penthouse under progress
-
Door frame fixing up to 7th floor completed. Above floors under progress
-
Window grill fixing up to 7th floor completed. Balance under progress
-
Internal tiling works up to 3rd floor completed, 4th & 5th floor under progress
-
Internal plumbing work 12th & 13th floor under progress
-
Internal electrical work 12th & 13th floor under progress
-
Lift front wall block work up to 9th floor completed. Balance under progress
-
Lift shaft works under progress
-
Electrical & plumbing work 10th and 11th floor under progress
​
Tower 2A and 2B
-
Flats handing over work under progress (clients)
-
All flats snagging work under progress (clients check list for hand over)
-
All flats plumbing fixtures fixing work completed
-
Corridor and staircase house keeping works under progress
-
All floors maintaince works under progress
Basement works
-
Lower and upper exit ramp flooring concrete and finishing work completed
-
Lower and upper entry ramp flooring concrete and finishing work yet to start
-
Lower and upper basement gas cutting work completed (all sides RCC wall studs and columns)
-
Upper basement screed concrete completed
-
Fire fighting pipe line fixing work completed
-
From 1A podium to 2A upper basement entry RCC work completed (ready to access directly to upper basement)
-
2A and 2B upper basement house keeping work under progress
External works (Hardscape & Softscape)
-
North side compound with drain work completed up to 2A tower entrance of the podium
-
South side compound with drain work completed up to 2A tower entrance of the podium
-
East side compound with feature elavation works completed
-
North side courtyard works completed in 2A and 2B. South side under progress
-
Electrical poles fixing work completed
-
STP RCC walls concrete work completed, STP above ramp works RCC works completed
-
Front compound plastering work under progress
-
Front gate structure work completed. Finishing work under progress
-
Security cabin structure and plastering work completed
-
Pathway pavers in 2A and 2B north side completed, south side under progress

Tower 1A
-
Upper terrace all concrete works completed.
-
Upper terrace OHT internal water proofing works under progress.
-
West side 8th floor to terrace floor plastering work completed.
-
Block work lift and basement under progress.
-
Balcony Railings fixing work 95% completed, balance under progress.
-
Door frame fixing up to 8th floor completed, 9th floor under progress.
-
Window Grill fixing upto to 4th to 7th floor completed, 8th and 9th floor under progress.
-
Internal plastering upto 8th floor completed, 9th floor marking under progress.
-
Tiling work upto 7th floor completed, 8th and 9th floor under progress.
-
Internal toilet plumbing line up to 12th floor completed, balance under progress.
-
Internal toilet electrical chiseling lines & conduit fixing up to 12th floor completed, balance under progress.
-
Internal toilet electrical wires pulling up to 5th floor completed, balance under progress.
-
Podium work concrete 100% completed, Ramp side wall work under progress.
-
Water proofing works 11 and penthouses under progress. Terrace brick bat work under progress.
Tower 1B
-
Terrace slab de-shuttering work under progress.
-
Above terrace head rooms columns concrete work completed.
-
Elevation pergola RCC works completed.
-
Terrace parapet upstanding beams completed.
-
Block work 11th floor 3 flats completed, under progress (penthouses block work under progress).
-
External plastering 4th floor to 8th floor completed.
-
Door frame fixing up to 5th floor completed (6 & 7th floor under progress).
-
Window grill fixing up to to 6th floor completed (Balance under progress).
-
Internal plastering 5th & 6th floor under progress.
-
Internal plumbing work upto 9th & 10th floor under progress.
-
Internal electrical work up to 9th & 10th floor under progress.
-
Water proofing works up to 9th floor completed, 10th under progress.
-
Podium ramp RCC works completed.
-
Balcony railings fixing work 4th to 8th floor under progress.
Basement Works
-
Lower and upper exit ramp flooring concrete and finishing work completed.
-
Lower and upper entry ramp flooring concrete and finishing work yet to start.
-
Upper and upper basement gas cutting work completed (all sides RCC wall studs and columns).
-
Upper basement screed concrete completed.
-
Fire fighting pipe line fixing work completed.
-
From 1A podium to 2A upper basement entry RCC work completed (Ready to access directly to upper basement).
-
2A and 2B Upper basement housekeeping works under progress.

Tower 1A
-
Upper terrace works like SHR, LHR, Pergolas, and elevation pillars concrete work completed.
-
Upper terrace OHT top slab completed.
-
West side 8th floor to terrace floor plastering work completed.
-
North side 8th to terrace plastering completed.
-
Block work parapet walls completed, lift and staircase head rooms under progress.
-
Balcony railings fixing work all floors completed, except hoist running area.
-
Door frame fixing up to 7th floor completed, 8th floor under progress.
-
Window grill fixing 4th to 7th floor completed.
-
Internal plastering up to 7th floor completed, 8th floor marking under progress.
-
Tiling work up to 7th floor completed.
-
Internal toilet plumbing line up to 12th floor completed, balance under progress.
-
Internal toilet electrical chiseling lines & conduit fixing up to 12th floor completed, balance under progress.
-
Internal toilet electrical wires pulling up to 3rd floor completed, balance under progress.
-
Podium work concrete up to 85% completed, balance under progress.
-
Water proofing works up to 10th floor completed, 11th floor and penthouses under progress.
​
Tower 1B
-
Terrace slab concrete work completed.
-
Above terrace OHT & head rooms columns concrete work under progress.
-
Elevation pergola column shuttering work under progress.
-
Terrace parapet upstanding beams under progress.
-
Block work 10th floor completed, 11th floor under progress.
-
External plastering 4th floor to 8th floor completed.
-
Door frame fixing up to 5th floor completed. 6th & 7th floor under progress.
-
Window grill fixing up to 6th floor completed. Balance under progress.
-
Internal plastering up to 4th floor completed, 5th & 6th floor button mark under progress.
-
Internal plumbing work up to 8th floor completed. 9th floor under progress.
-
Internal electrical work up to 9th floor completed. 10th floor under progress.
-
Water proofing works up to 8th floor completed, 9th floor under progress.
-
Podium ramp excavation work completed. Foundation work under progress.
-
Balcony railings fixing work 4th to 8th floor under progress.
​
Tower 2 A & 2B
-
Flats handing over work under progress.
-
All flats snagging work under progress.
-
All flats plumbing fixtures fixing work under progress.
-
Corridor and staircase house keeping works under progress.
-
Penthouses wooden staircase work completed.
Basement works
-
Lower & upper exit ramp flooring concrete and finishing work completed.
-
Lower & upper entry ramp flooring concrete and finishing work yet to start.
-
Upper & upper basement gas cutting work completed.
-
Upper basement screed concrete completed.
-
Fire fighting pipe line fixing work completed.
-
From 1A podium to 2A upper basement entry RCC work completed.
-
2A & 2B Upper basement house keeping works under progress.

Tower 1A
-
Upper terrace works like SHR, LHR, Pergolas and elevation pillars concrete work completed.
-
Upper terrace OHT side walls completed, top slab shuttering work under progress.
-
West side 8th floor to terrace floor plastering work completed.
-
North side scaffolding erection work completed, plastering under progress.
-
Block work upper penthouse completed. Parapet walls near expansion joint under progress.
-
Balcony railings fixing work 9th to penthouse under progress.
-
Door frame fixing up to 7th floor under progress.
-
Window grill fixing up 4th to 7th floor under progress.
-
Internal plastering 5th and 6th floor completed. 7th floor under progress.
-
Tiling work 4th and 5th floor completed, 6th and 7th floor under progress.
-
Internal toilet plumbing line up to 10th floor completed, 11th floor under progress.
-
Internal electrical works up to 11th floor completed, penthouses under progress.
-
Podium work concrete up to 70% completed, balance under progress.
-
Water proofing works up to 10th floor completed, 11th and penthouses under progress.
Tower 1B
-
Upper penthouse floor concrete work completed.
-
Upper penthouse to terrace slab, first three flats column concrete work completed.
-
Upper penthouse to terrace slab, Balance three flats column concrete work under progress.
-
Terrace slab first three flats shuttering work under progress.
-
Block work in 9th floor completed. 10th floor under progress.
-
External plastering 4th to 8th floor completed.
-
Door frame fixing up to 4th floor completed. Further under progress.
-
Window grill fixing up to 4th floor completed. Further under progress.
-
Internal plastering up to 3rd floor completed. 4th floor under progress. 5th floor button mark under progress.
-
Internal plumbing work up to 8th floor completed. 9th floor under progress.
-
Internal electrical work up to 9th floor completed. 10th floor under progress.
-
Water proofing works up to 8th floor completed, 9th under progress.
-
Podium ramp excavation work completed. Foundation work under progress.
-
Balcony railings fixing work 4th to 8th floor under progress.
Tower 2A
-
Flats handing over work under progress.
-
In all flats snagging work under progress.
-
In all flats plumbing fixtures fixing work under progress.
-
In the corridor and staircase house keeping works under progress.
-
Penthouses wooden staircase posing work completed.
Basement works
-
Lower & Upper exit ramp flooring concrete and finishing work completed.
-
Lower & Upper Entry Ramp flooring concrete and finishing work yet to start.
-
Upper & Upper basement gas cutting work completed (all sides RCC wall studs & Columns).
-
Upper basement Screed concrete completed.
-
Fire fighting pipe line fixing work completed.
-
From 1A podium to 2A upper basement entry RCC work completed (Ready to access next week).
-
Columns & ceiling touchup works completed.

Tower 1 A
-
Upper terrace works like SHR, LHR, Pergolas, and elevation pillars concrete work completed.
-
Upper terrace OHT side walls shuttering work under progress.
-
8th floor to terrace floor west side scaffolding completed, plastering under progress.
-
Block work upper penthouse and terrace parapet walls under progress.
-
Balcony railings fixing work 9th to penthouse under progress.
-
Door frame fixing up to 7th floor under progress.
-
Window grill fixing up 4th to 7th floor under progress.
-
Internal plastering 5th & 6th floor under progress. 7th floor button mark under progress.
-
Tiling work 4th floor under progress.
​
Tower 1 B
-
Lower penthouse floor concrete work completed.
-
Lower to upper penthouse first three flats column concrete work completed.
-
Block work in 9th floor under progress.
-
External plastering 4th to 8th floor under progress (80% completed). Balance under progress.
-
Door frame fixing up to 3rd floor completed.
-
Window grill fixing up to 3rd floor completed.
-
Internal plastering 1st to 3rd floor under progress. Balance floors button mark under progress.
​
Tower 2 A & 2B
-
Lobby flooring granite work completed.
-
Lobby false ceiling with wiring work completed.
-
Lobby putty work under progress.
-
Lobby joinery work completed (hardware fittings pending).
-
Lobby front steps flooring granite work under progress.
-
In all flats snagging work under progress (clients check list for hand over).
-
In all flats fixtures fixing work under progress (85% completed).
-
Penthouses staircase wooden threads polish work under progress.
​
Basement
-
Lower basement chamber cleaning & finishing work completed.
-
Lower basement ceiling electrical checking works completed.
-
Upper basement gas cutting work under progress (all sides RCC wall studs & Columns).
-
Upper basement screed concrete under progress (60% completed).
-
Fire fighting pipe line fixing work completed.
-
Columns & ceiling touchup works under progress.

Tower 1 A
-
Upper terrace works like SHR, LHR, Pergolas and elevation pillars concrete work completed.
-
Upper terrace OHT bottom slab shuttering work under progress.
-
8th floor to terrace floor scaffolding under progress.
-
Block work lower penthouse and terrace parapet walls under progress.
-
Balcony railings fixing work 9th to penthouse under progress.
-
Door frame fixing up to 5th floor completed.
-
Window grill fixing up to to 4th floor completed.
-
Internal plastering 4th & 5th floor under progress. 6th floor button mark under progress.
-
Tiling work 1st floor to 3rd floor under progress.
​
Tower 1 B
-
11th floor slab concrete work completed.
-
11th to 12th floor first three flats column concrete work completed. Shuttering work progress.
-
Block work in 8th floor completed, 9th marking course under progress.
-
External plastering 4th floor to 8th floor under progress (80% completed). Balance under progress.
-
Door frame fixing up to 3rd floor completed.
-
Window grill fixing up to 3rd floor completed.
-
Internal plastering 1st to 3rd floor under progress. Balance floors button mark under progress.
​
Tower 2 A & 2B
-
Lobby flooring granite work completed.
-
Lobby false ceiling with wiring work completed.
-
Lobby putty work under progress.
-
Lobby joinery work completed (hardware fittings pending)
-
Lobby front steps flooring granite work completed.
-
In all flats snagging work under progress (clients check list for hand over).
-
In all flats fixtures fixing work under progress (75% completed).
-
Penthouses staircase wooden threads polish work under progress.
​
Basement
-
Lower basement chamber cleaning & finishing work completed.
-
Lower basement ceiling electrical checking works completed.
-
Upper & Upper basement gas cutting work under progress (all sides RCC wall studs & columns)
-
Upper basement screed concrete under progress (60 % completed)
-
Fire fighting pipe line fixing work completed.
-
Columns & ceiling touchup works under progress.

Tower 1 A
-
Terrace Slab completed.
-
Upper terrace works like head rooms and pergola shuttering work under progress.
-
External plastering up to 8th floor completed. 8th floor to terrace floor scaffolding under progress.
-
Block work lower pent house under progress.
-
Balcony railings fixing work up to 8th floor completed. Balance under progress.
-
Internal plastering 1st to 3rd floor under progress. Balance floors button mark under progress.
​
Tower 1 B
-
10th floor balance three flats concrete work completed.
-
11th floor first three flats column concrete work under progress.
-
Block work in seventh floor completed, 8th floor under progress.
-
External plastering up to 4th floor completed. 4th floor to 8th floor under progress, 50% completed.
-
Internal plastering 1st to 3rd floor under progress. Balance floors button mark under progress.
​
Tower 2 A
-
Lobby flooring granite work completed.
-
Lobby false ceiling with wiring work completed.
-
Lobby putty work under progress.
-
Lobby joinery work completed (hardware fittings pending)
-
Lobby front steps flooring granite work under progress.
-
In all flats snagging work under progress.(Clients check list for hand over)
-
In all flats fixtures fixing work under progress, 50% completed.
-
Penthouses staircase wooden threads polish work under progress.
​
Tower 2 B
-
Lobby flooring granite work completed.
-
Lobby false ceiling with wiring work completed.
-
Lobby putty work under progress.
-
Lobby joinery work completed (Hardware fittings pending)
-
Lobby front steps flooring granite work under progress.
-
In all flats snagging work under progress. (Clients check list for hand over)
-
In all flats fixtures fixing work under progress, 50% completed.
-
Penthouses staircase wooden threads polish work under progress.

Tower 1A
-
Lower penthouse floor first three flats concrete work completed.
-
Lower penthouse floor balance three flats shuttering work under progress.
-
External plastering upto 7th floor completed.
-
Block work 9th floor under progress.
-
Balcony railings fixing work under progress.
-
Internal plastering 1st floor under progress. 2nd floors button mark under progress.
​
Tower 1B
-
8th floor first three flats concrete work completed.
-
8th floor balance three flats ready to pour concrete.
-
Block work in 6th floor under progress.
-
1B fire fight driveway (east side podium) area concrete work completed.
-
Balcony railings work under progress.
-
External plastering up to 3rd floor under progress.
​
Tower 2A
-
Corridor one coat colour under progress.
-
Common and fire fighting staircase surrounding one colour under progress.
-
Penthouses internal staircases wood work for thread under progress.
-
Penthouses internal putty work under progress.
-
Fire fighting doors and shaft doors fixing work under progress.
-
External colour second coat 50% completed. Balance work under progress.
-
All flats house keeping, acid wash and soap wash under progress.
​
Tower 2B
-
Corridor one coat colour under progress.
-
Common and fire fighting staircase surrounding one colour under progress.
-
Penthouses internal staircases wood work for thread under progress.
-
Penthouses internal putty work under progress.
-
Fire fighting doors and shaft doors fixing work under progress.
-
External colour second coat 50% completed.
-
All flats house keeping, acid wash and soap wash under progress.
-
Upto 5 floors internal colour completed.

Tower 1A
-
11th floor balance three flats concrete work completed.
-
11th & 12 floor first three flats shuttering work under progress.
-
External plastering up to 3rd floor completed. 4th floor to 7th floor under progress.
-
Block work 8th floor under progress.
-
Balcony railings fixing work under progress.
-
Internal plastering 1st to 3rd floor under progress. Balance floors button mark under progress.
​
Tower 1B
-
8th floor first three flats concrete work completed.
-
8th floor balance three flats ready to pour concrete.
-
Block work in 6th floor under progress.
-
1B fire fight driveway (east side Podium) area concrete work completed.​
​
Tower 2A
-
Corridor one coat colour under progress.
-
Common and fire fighting staircase surrounding one colour under progress.
-
Pent houses internal staircases wood work for thread under progress.
-
Pent houses internal putty work under progress.
-
Fire fighting doors and shaft doors fixing work under progress.
-
External colour second coat 50% completed. Balance work under progress.
-
All flats house keeping, acid wash and soap wash under progress.
​
Tower 2B
-
Corridor one coat colour under progress.
-
Common and fire fighting staircase surrounding one colour under progress.
-
Pent houses internal staircases wood work for Thread under progress.
-
Pent houses internal putty work under progress.
-
Fire fighting doors and shaft doors fixing work under progress.
-
External colour second coat 50% completed.
-
All flats house keeping, acid wash and soap wash under progress.
-
Up to 5 floors internal colour completed.

Tower 2A
-
Corridor tiles laying upto penthouse floor completed.
-
Common and fire fighting Staircase tiling up to terrace completed.
-
Internal plastering of pent houses completed.
-
All flats house keeping work completed. Acid wash and soap wash under progress.
​
Tower 2B
-
Corridor tiles laying upto pent house completed.
-
Common and fire fighting Staircase flooring upto terrace completed.
-
Flats internal Tiles laying upto Pent houses 100% completed.
-
External Glass work in progress.
​
Tower 1A
-
11th floor completed.
-
External plastering upto the 7th floor under progress.
​
Tower 1B
-
7th floor completed.
-
1B driveway area, UG Sump above ramp concrete work completed.

Tower 1A
-
11th floor first three flats shuttering and bar bending work under progress.
-
10th to 11th floor balance three flats columns concrete work under progress.
-
External plastering up to 3rd floor completed. 4th floor to 7th floor under progress.
-
Block work 8th floor under progress.
-
Marketing and site office finishing works under progress (Flat No 001 & 005).
Tower 1 B
-
Sixth floor balance three flats concrete work completed.
-
Sixth floor to 7th floor first three flats column concrete work under progress.
-
Block work in fourth floor under progress. 1B driveway (Podium) area shuttering and barbending work copmleted.
-
1B driveway (Podium) area (east side) Excavation and rock work under progress.
Tower 2 A
-
Corridor tiles laying up to 12th floor completed.
-
Common and fire fighting Staircase tiling up to 12th floor completed.
-
MS works in internal flats completed (Window Grills). Staircase railings completed. Pent houses individual staircase completed.
-
Internal plastering pent houses completed.
-
Flats internal Tiles laying up to Pent houses 100% completed.
-
External primer and colour applying one coat is over, second coat started.
-
All flats house keeping work completed. Acid wash and soap wash started.
Tower 2 B
-
Corridor tiles laying up to 12th floor completed.
-
Common and fire fighting Staircase tiling up to 12th floor completed.
-
Pent house tiling under progress.
-
MS works in internal flats under progress (Window Grills). Staircase railings completed.
-
Internal plastering pent houses completed except some touch up works.
-
Flats internal Tiles laying upto 10th floor completed. Pent houses under progress. External plastering 100 % completed.
-
External primer and colour applying work under progress.

Tower 1A
-
10th floor First three flats concrete work competed.
-
10th floor Balace three flats shuttering and bar-bending work completed, ready to pour concrete.
-
Block work Fifth and Sixth floor under progress.
-
External plastering started in North & North west corner (4 and 5 flats series).
-
Marketing and site office finishing works under progress (Flat No 001 & 005).
Tower 1B
-
Fifth floor Balance three flats concrete work completed.
-
Fifth floor to sixth floor column concrete work under progress.
-
Block work in Second and Third floor under progress.
-
Excavation in UG Sump and 1B driveway (Podium) area completed. Balance work under progress.
​
Tower 2A
-
Corridor tiles laying up to 12th floor completed.
-
Common and fire fighting Staircase tiling up to 12th floor completed.
-
Pent house tiling under progress.
-
MS works in internal flats under progress (Window Grills).
-
Staircase railings completed. Pent houses individual staircase under progress.
-
Internal plastering pent houses completed except some touch up works.
-
Flats internal Tiles laying upto 10th floor completed. Pent houses under progress.
-
External primer and colour applying work under progress.
Tower 2B
-
Corridor tiles laying up to 12th floor completed.
-
Common and fire fighting Staircase tiling up to 12th floor completed.
-
Pent house tiling under progress.
-
MS works in internal flats under progress (Window Grills). Staircase railings under progress. Pent houses individual staircase under progress.
-
Internal plastering pent houses completed except some touch up works.
-
Flats internal Tiles laying up to 10th floor completed.
-
External plastering 100 % completed.
-
External primer and colour applying work under progress.

Tower 1 A
-
9th floor to 10th floor first three flats columns concrete under progress.
-
9th floor balance three flats concrete work completed.
-
Block work Fourth and Fifth floor under progress.
​
Tower 1 B
-
Fourth floor Balance three flats concrete work completed.
-
Forth to Fifth floor first three flats columns concrete under progress.
-
Block work in Ground and 1st floor under progress.
-
Excavation under progress near east side podium area.
Tower 2 A
-
Corridor tiles laying up to 12th floor completed.
-
Common and fire fighting staircase tiling up to 12th floor completed.
-
Pent house tiling under progress.
-
MS works in internal flats under progress (Window Grills). Staircase railings completed. Pent houses individual staircase under progress.
-
Internal plastering pent houses completed except some touch up works.
-
Flats internal Tiles laying up to 10th floor completed.
-
External primer and colour applying work under progress.
Tower 2 B
-
Corridor tiles laying up to 12th floor completed.
-
Common and fire fighting Staircase tiling up to 12th floor completed.
-
Pent house tiling under progress.
-
MS works in internal flats under progress (Window Grills). Staircase railings under progress. Pent houses individual staircase under progress.
-
Internal plastering pent houses completed except some touch up works.
-
Flats internal Tiles laying up to 10th floor completed.
-
External plastering 100 % completed.
-
External primer and colour applying work under progress.

Block 2A
-
Corridor tiling under progress in 10th to 5th floor.
-
Staircase railings under progress from 12th to 5th floor.
-
External plastering completed.
-
MS works 7th to pent houses under progress.
-
Internal plastering of penthouses under progress.
-
Flats internal Tiling upto 10th floor completed.
-
External primer and colour applying work under progress.
​
Block 2B
-
Corridor tiles laying under progress in 10th to 5th floor.
-
Staircase railings under progress in 12th to 5th floor.
-
External plastering 7th to Terrence 75% completed, balance under progress.
-
Internal plastering lower and upper pent houses under progress.
-
Flats internal tiles laying up to 10th floor completed.
-
External primer applying work under progress.
​
Block 1A
-
8th floor balance three flats concrete completed .
-
8th floor 9th floor columns under progress.
-
Block work Third and Fourth floor under progress.
​
Block 1B
-
Third floor balance three flats concrete completed.
-
Third to fourth floor first 3 flats column casting under progress.
-
Block work in Ground floor started.
-
Excavation under progress near east side podium area.

Tower 1 A
-
8th floor first three flats shuttering and bar bending work cpmpleted, ready to pour concrete.
-
8th floor balance three flats column concrete completed. Shuttering work under progress.
-
Third and Fourth floor under progress.
Tower 1 B
-
Third floor first three flats concrete completed.
-
Second floor to third floor balance three flats columns concrete work completed, shuttering work progress.
-
Excavation under progress near east side podium area.
Tower 2 A
-
Over Head Tanks concrete works completed.
-
Block work in lift opening side walls completed.
-
External plastering south under progress.(7th floor to terrace, near south side)
-
MS works 7th to pent houses under progress.
-
Internal plastering pent houses under progress.
-
Tiles laying up to 10th floor completed.
Tower 2 B
-
Terrace Lift head room and Staircase head room, OHT concrete work completed.
-
Lower pent house and upper pent house block work completed.
-
External plastering 7th to Terrace floor under progress.
-
Internal plastering lower and upper pent houses under progress.
-
Tiles laying work up to 10th floor completed.

Block 2A
-
Over Head Tanks concrete works completed.
-
Block work completed in lift opening side walls.
-
External plastering under progress in 7th floor to terrace- south side. Balance plastering completed.
-
MS works 7th to pent houses under progress.
-
Internal plastering pent houses under progress.
-
Tiles laying work completed upto 10th floor.
​
Block 2B
-
Terrace Lift head room and Staircase head room, OHT concrete work completed.
-
Block work completed in Lower pent house and upper pent house.
-
External plastering under progress in 7th to Terrace floor.
-
Internal plastering under progress in lower and upper pent houses.
-
Tiles laying work completed upto 10th floor.
​
Block 1A
-
8th floor first three flats shuttering and barbending work completed, ready for concreting.
-
8th floor balance three flats column concrete completed. Shuttering work under progress.
-
Block work under progress in Third and Fourth floor.
​
Block 1B
-
Third floor first three flats concrete completed.
-
Second floor to third floor balance three flats columns concrete work completed, shuttering work under progress.
-
Excavation under progress near east side podium area.
​
External Works (Hardscape):
-
North side compound (upto building expansion joint) RCC wall and drain wall work progress.
-
Balance excavation under progress.

Block 2A
-
Over Head Tanks concrete works completed.
-
Block work completed in lift opening side walls.
-
External plastering under progress in 7th floor to terrace- south side. Balance plastering completed.
-
MS works 7th to pent houses under progress.
-
Internal plastering pent houses under progress.
-
Tiles laying work completed upto 10th floor.
​
Block 2B
-
Terrace Lift head room and Staircase head room, OHT concrete work completed.
-
Block work completed in Lower pent house and upper pent house.
-
External plastering under progress in 7th to Terrace floor.
-
Internal plastering under progress in lower and upper pent houses.
-
Tiles laying work completed upto 10th floor.
​
Block 1A
-
8th floor first three flats shuttering and barbending work completed, ready for concreting.
-
8th floor balance three flats column concrete completed. Shuttering work under progress.
-
Block work under progress in Third and Fourth floor.
​
Block 1B
-
Third floor first three flats concrete completed.
-
Second floor to third floor balance three flats columns concrete work completed, shuttering work under progress.
-
Excavation under progress near east side podium area.
​
External Works (Hardscape):​
-
North side compound (upto building expansion joint) RCC wall and drain wall work progress.
-
Balance excavation under progress.

Block 2A
-
Terrace Lift head room and Staircase head room slabs completed. OHT under progress.
-
Block work upper pent house and parapet walls under progress.
-
External plastering north and west side, 7th to terrace - 50% completed. Balance under progress.
-
MS works 7th to 10th floor under progress.
-
Internal plastering 10 th floor under progress.
-
Tiles laying upto 10th floor completed except some sold flats.
​
Block 2B
-
Terrace Lift head room and Staircase head room, OHT under progress.
-
lower pent house and upper pent house block work under progress.
-
External plastering up to 7th floor completed.
-
Internal plastering 8th floor completed, 9th and 10th under progress.
-
Tiles laying work up to 8th floor completed. 9th floor under progress.
​
Block 1A
-
Sixth floor first three flats concrete work completed.Balance flats shuttering work under progress.
-
Sixth floor to seventh floor columns concrete work under progress (first three flats)
-
Ground and first floor block work under progress.
​
Block 1B
-
first floor 3 flats slab cocrete completed.
-
Ground to first floor balance flats column concrete work under progress.
-
Excavation under progress near east side podium area.

Block 2A
-
Terrace parapet works under progress.
-
Block work upper pent house under progress.
-
Internal plastering is completed upto 7th floor and 8th floor is under progress MS works under progress from 3rd to 7th floor.
-
Tiles laying work completed upto 7th floor.
​
Block 2B
-
Concrete work completed till upper pent house.
-
Column concrete work under progress from upper pent house to terrace slab.
-
Block-work completed till 10th floor.
-
External plastering completed till 7th floor.
-
Internal plastering works under progress in 7th floor.
-
Tiles laying work completed till 3rd floor and 4th & 5th floor under progress.
​
Block 1A
-
Concrete work completed till 4th floor.
-
Column concrete work under progress from 4th to 6th floor.
-
Block-work under progress in ground floor’.
​
Block 1B
-
Concrete work completed in ground floor.
-
Shuttering work under progress in ground floor.
